Transitioning to renewable solar energy represents a prime capital funding opportunity for residential house owners, industrial developers, and industrial operators alike. While the lengthy-time period advantages of reduced application bills and carbon emission cuts are clear, navigating upfront financial commitments calls for absolute precision. Without particular pre-production forecasting, unexpected costs during racking, electrical interconnection, or battery integration can swiftly drain projected earnings margins. Reliable solar value estimation bridges the distance between smooth electricity goals and monetary truth. By establishing based price range framework early, stakeholders protect their ROI and ensure clean execution from initial site evaluation to final grid connection.
Establishing Accurate Financial Frameworks During Early Feasibility
Before mounting a single photovoltaic module, a solar development calls for a complete financial and placement feasibility analysis. Sizing the array in simple terms on square footage often leads to underperforming installations or unnecessary hardware charges that burden the proprietor long-term.
- Consumption Analysis: Audits historical energy utilization patterns throughout peak and off-peak operational seasons.
- Geotechnical & Roof Audits: Verifies structural load capability and identifies shading obstructions before design.
- Incentive Mapping: Factors in tax credit, local rebates, and net-metering systems to determine net capital necessities.
Leveraging specialized construction cost estimating services throughout the pre-development stage gives investors a realistic view of fabrication times, civil site training needs, and total capital expenditure goals.
Balancing Electrical System Engineering with Equipment Costs
The photovoltaic panels themselves account for only a fraction of a solar electricity system’s overall balance of plant cost. Inverters, step-up transformers, wiring runs, and predominant service panel improvements shape the central electric spine that in the end determines machine reliability and system output performance over the years.
- Inverter Architecture Selection: Evaluates microinverters, string inverters, or energy optimizers based on shading profiles.
- Interconnection Planning: Identifies essential software grid interface upgrades earlier than hardware procurement starts.
- Battery Energy Storage Systems: Sizes lithium-ion bank capacities to balance peak-shaving needs against in-advance battery fees.
Engaging professional electrical estimating services guarantees that high-voltage cabling, circuit safety, and labor hours are priced accurately, preventing budget surprises at the point of active site wiring and final inspection.

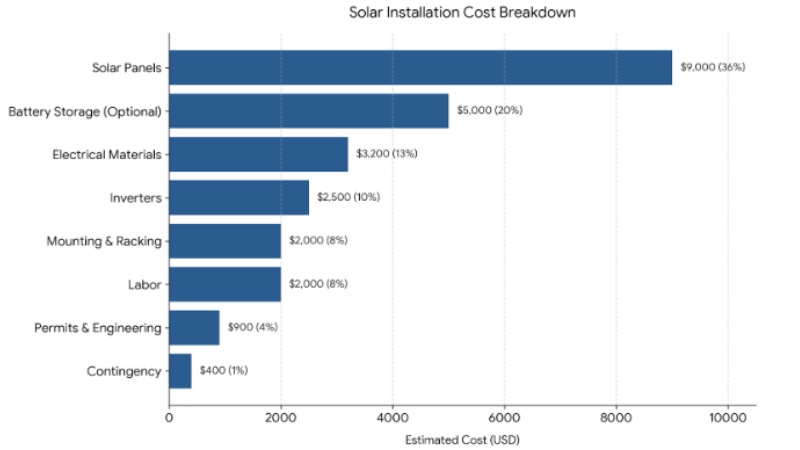

| Cost Component | Estimated Cost (USD) | Percentage of Total Budget |
| โ๏ธ Solar Panels | $9,000 | 36% |
| ๐ Inverters | $2,500 | 10% |
| ๐๏ธ Mounting & Racking | $2,000 | 8% |
| โก Electrical Materials | $3,200 | 13% |
| ๐ Battery Storage (Optional) | $5,000 | 20% |
| ๐ท Labor | $2,000 | 8% |
| ๐ Permits & Engineering | $900 | 4% |
| ๐ก๏ธ Contingency | $400 | 1% |
| ๐ฐ Total Estimated Cost | $25,000 | 100% |
Streamlining Material Takeoffs to Eliminate Job Site Waste
Accurate material quantities form the basis of any successful commercial or application-scale sun setup. Underestimating racking additives or over-ordering specialized cabling creates highly-priced task friction that eats directly into general income margins and disrupts task completion timelines.
- Hardware Component Inventories: Maps specific portions of mounting rails, flashings, mid-clamps, and ground lugs.
- Cable and Conduit Schedules: Calculates actual wire lengths and conduit sizing based on distance runs to the distribution panel.
- Labor Coordination: Matches material delivery schedules directly with website online group set up quotes to lessen staging muddle.
Utilizing complete construction takeoff services lets in task managers stabilize aggressive supplier charges, eliminate excess fabric waste, and maintain staging logistics organized throughout the construction lifespan.

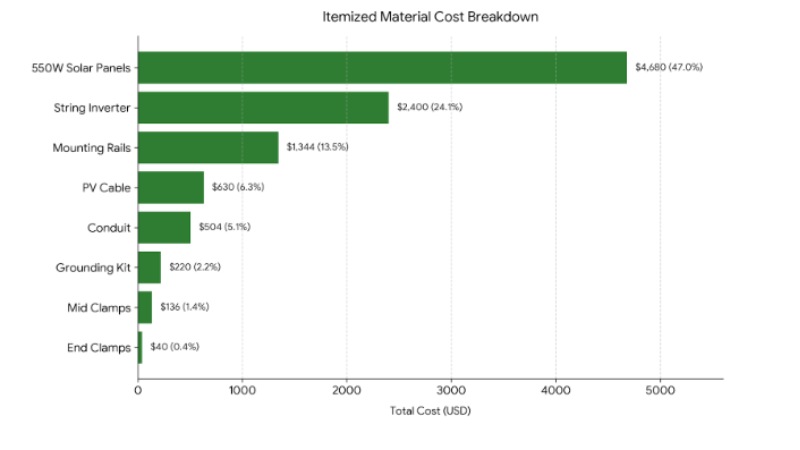

| Material | Quantity | Unit | Estimated Unit Cost | Total Cost |
| Solar & Inverter Equipment | ||||
| โ๏ธ 550W Solar Panels | 18 | Panels | $260.00 | $4,680.00 |
| ๐ String Inverter | 1 | Unit | $2,400.00 | $2,400.00 |
| Racking & Mounting Hardware | ||||
| ๐๏ธ Mounting Rails | 42 | Pieces | $32.00 | $1,344.00 |
| ๐ฉ Mid Clamps | 34 | Pieces | $4.00 | $136.00 |
| ๐ฉ End Clamps | 8 | Pieces | $5.00 | $40.00 |
| Electrical & Conduit | ||||
| ๐ PV Cable | 450 | ft | $1.40 | $630.00 |
| โก Conduit | 180 | ft | $2.80 | $504.00 |
| ๐ก๏ธ Grounding Kit | 1 | Set | $220.00 | $220.00 |
| Total Estimated Material Cost | $9,954.00 |
Mitigating Supply Chain Volatility and Soft Costs
A significant part of any solar assignment budget consists of soft costs, including neighborhood permitting, engineering seals, application interconnection expenses, and ongoing hard work overhead. Managing these variables calls for ongoing oversight, sturdy vendor partnerships, and relatively flexible scheduling models to hold mission momentum.
- Regulatory Compliance: Pre-documents all local building codes and fire protection clearances to cast off permitting holds.
- Vendor Price Locking: Negotiates fixed-charge material contracts to insulate the undertaking from global solar module fee swings.
- Risk Contingencies: Allocates committed contingency reserves particularly for unexpected structural or electric retrofits.
Rigorous administrative planning keeps assignment timelines intact, shielding the economic returns calculated at the point of initial system layout whilst mitigating market fluctuation risks throughout the global supply chain.

Maximizing Long-Term ROI Through Preventive Lifecycle Management
Executing a continuing setup is only the first step toward long-term renewable electricity reliability. Incorporating lifecycle issues and preventive maintenance protocols into early fee estimates guarantees that performance degradation remains within planned thresholds for 25 to 30 years.
- Performance Monitoring Systems: Integrates real-time IoT sensors to monitor string overall performance and detect faulty panels right away.
- Scheduled Panel Washing Programs: Budgeting for periodic cleansing prevents dust accumulation and soot buildup from degrading output.
- Inverter Replacement Provisioning: Reserves capital for mid-life inverter replacements around 12 to 15 years.
Factoring operational and upkeep expenses (O&M) into upfront feasibility models establishes sensible cash flow expectations, ensuring the system continues generating clean energy profitably long after preliminary capital payback milestones are achieved.
Final Thoughts
Solar electricity initiatives are long-term capital investments that require specific engineering, disciplined procurement, and transparent budget management. By prioritizing thorough fee planning, correct material takeoffs, and expert electrical estimates, developers make certain their renewable energy systems deliver reliable, cost-effective power for decades to come.
(FAQs)
- What elements influence the full cost of a solar panel installation?
Overall undertaking expenses depend upon array potential (kW rating), roof structure, panel performance, inverter architecture, battery storage additions, and labor costs. Non-hardware “tender charges”โalong with lets in, grid interconnection costs, and structural engineering sealsโadditionally represent a key percentage of the total budget.
- How do accurate material takeoffs save you sun mission delays?
Material takeoffs provide an actual inventory of racking rails, clamps, wiring lengths, and conduit accessories needed for the build. Having accurate quantities prevents shortages that stall site crews, while fending off extra material orders that muddle running regions and inflate staging expenses.
- Why are electrical estimations so important for commercial solar builds?
Commercial installations frequently require important panel improvements, step-up transformers, and long conduit runs to connect to utility infrastructure. Precise electrical estimations map out those complicated excessive-voltage necessities in advance, making sure the system meets local grid compliance without sudden retrofits.
- What is the distinction between string inverters and microinverters in cost planning?
String inverters have a decrease prematurely value however can experience overall system output loss if a single panel is shaded. Microinverters and power optimizers cost more upfront per panel; however, they maximize energy production throughout complex roofs with partial shading, delivering higher long-term ROI.
- How long does it generally take to recoup the investment on a solar system?
Most residential and commercial solar installations gain economic payback within 5 to 9 years, depending on nearby software electricity rates, available tax incentives, and daily sun hours. Beyond the payback threshold, the system produces clean power with minimal maintenance costs for a remaining 25+ year lifespan.
